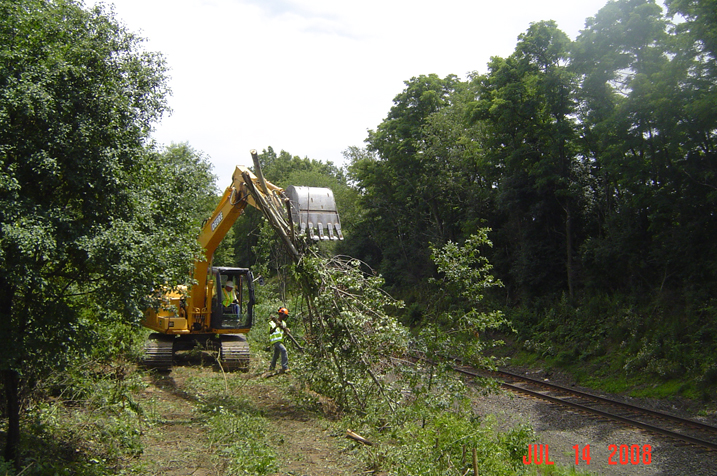

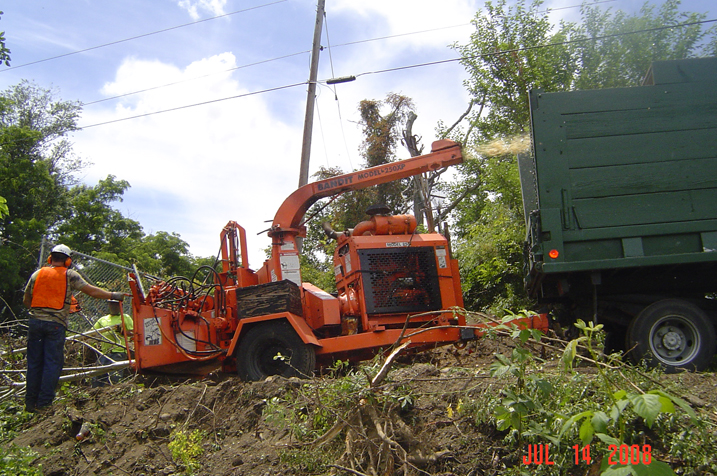

|
|
|
|
Clearing and grubbing for new access.
|
Clearing and grubbing for new access.
|

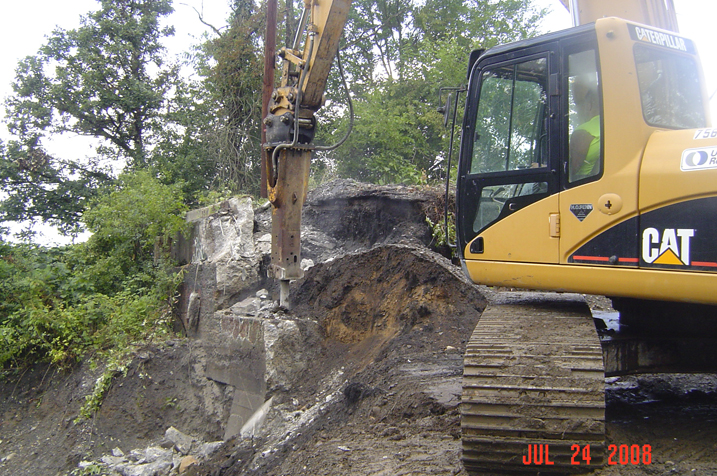

Removing existing bridge abutment for new access road.
|

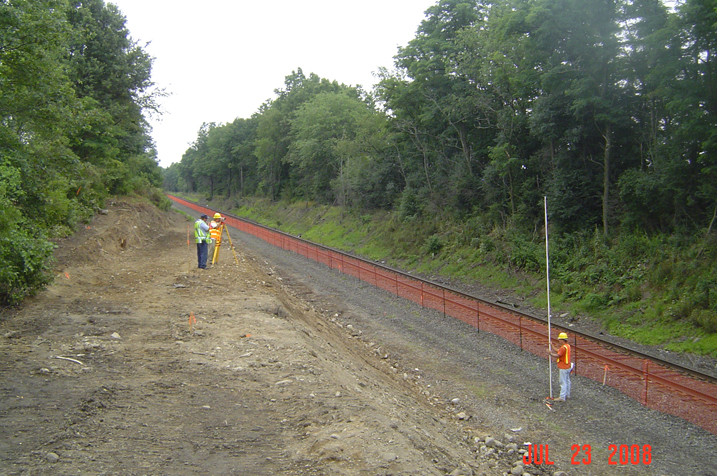

Surveying for new access road.
|
|
|
|
|

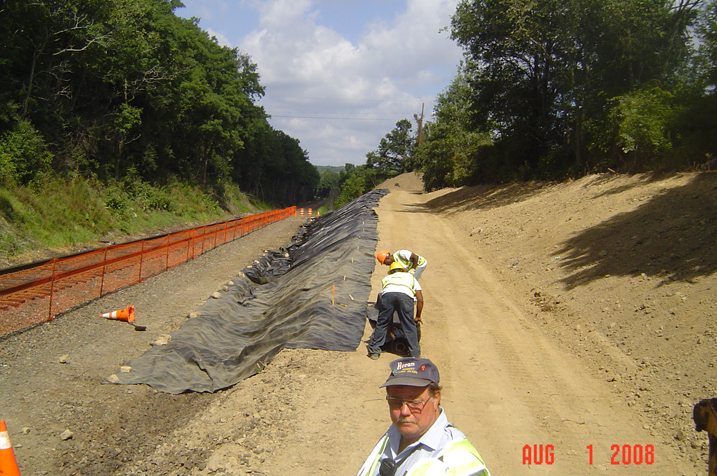

Stabilization fabric being installed on new access road.
|

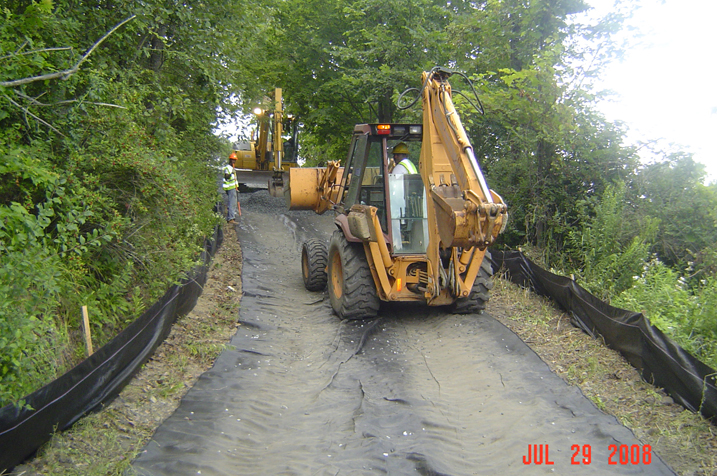

Grading item 4 on new access road.
|

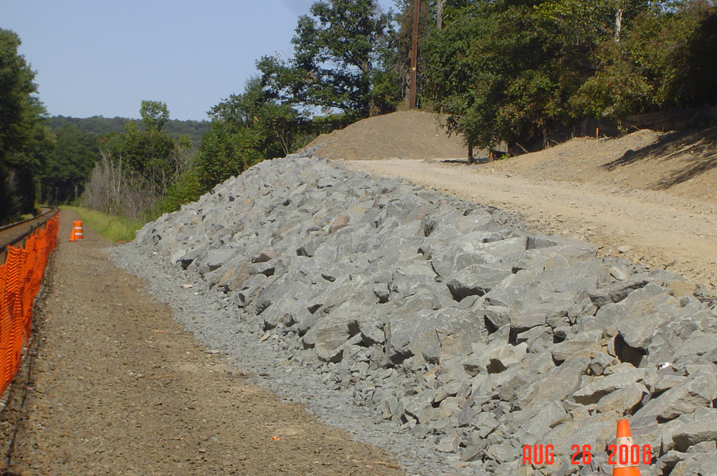

Armour stone installed on side of new access road.
|

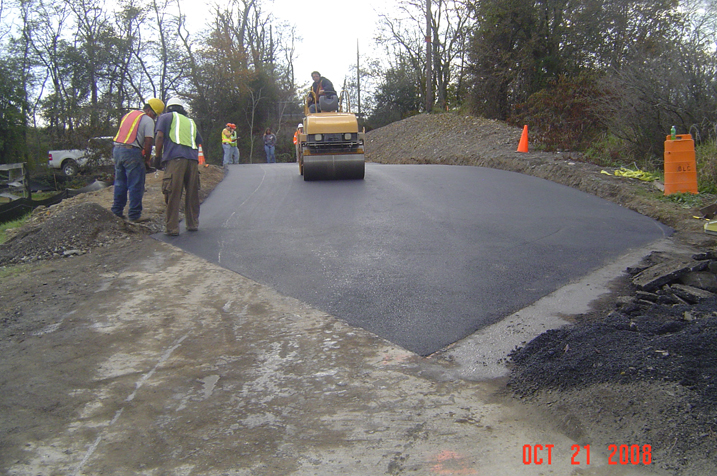

Asphalt paving at entrance to new access road.
|
|
|
|
|

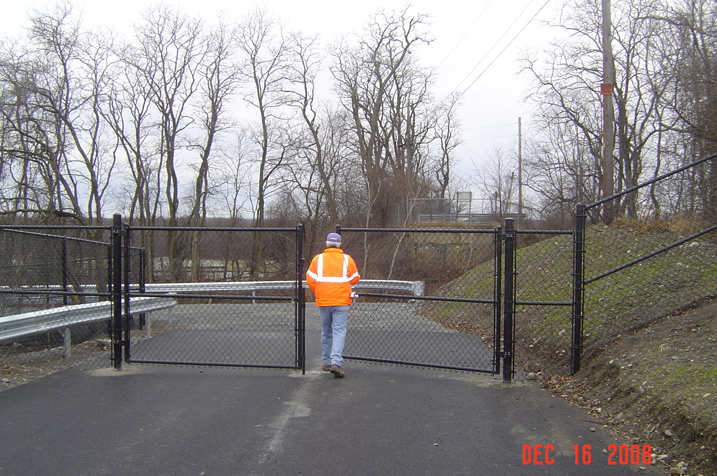

New gate, chainlink fencing and guide rail for new access road.
|

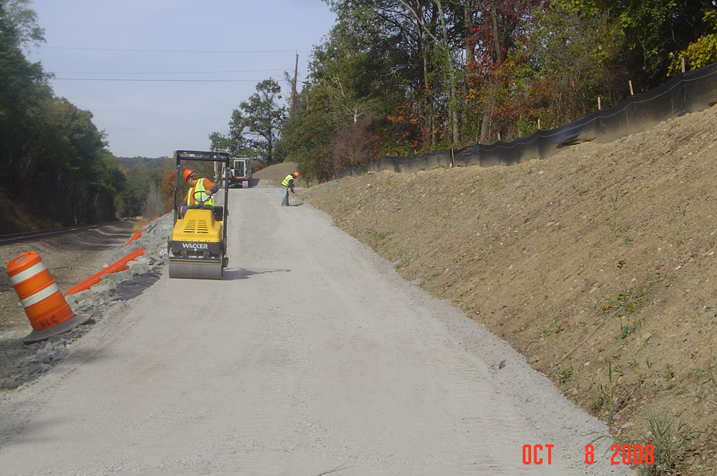

Regrading the Bird Sanctuary Road.
|

Temporary access paths were installed to work under bridge on east and west side.
|

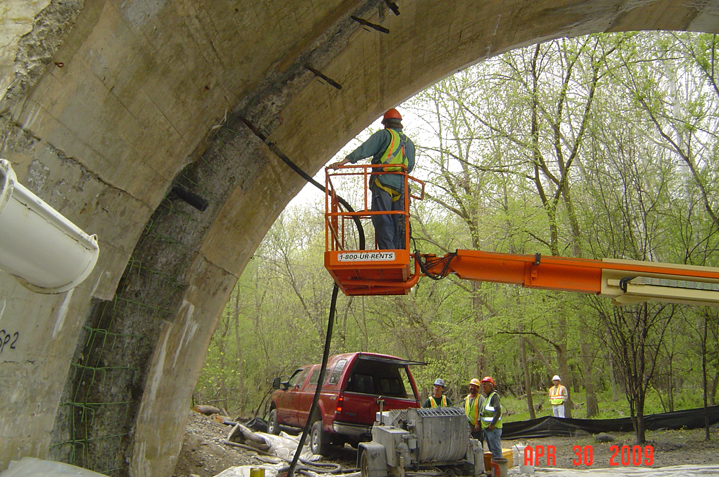

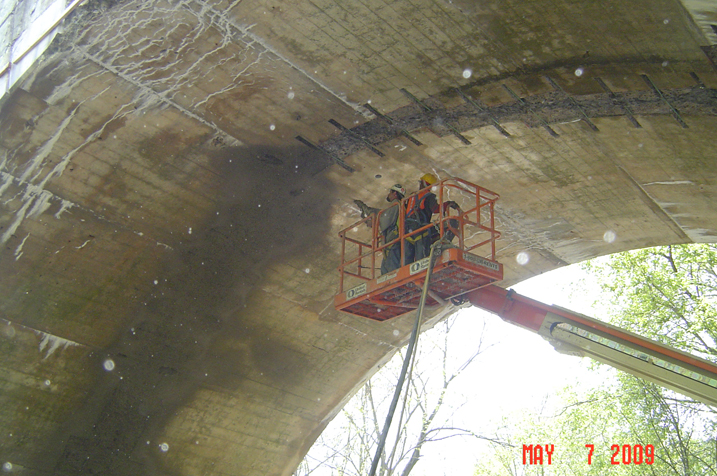

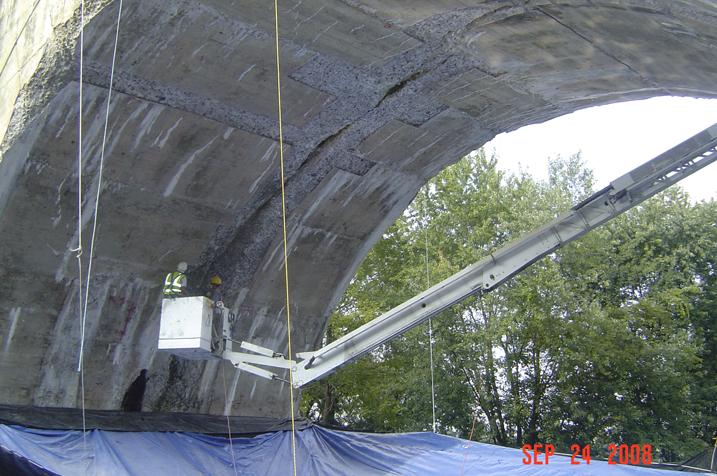

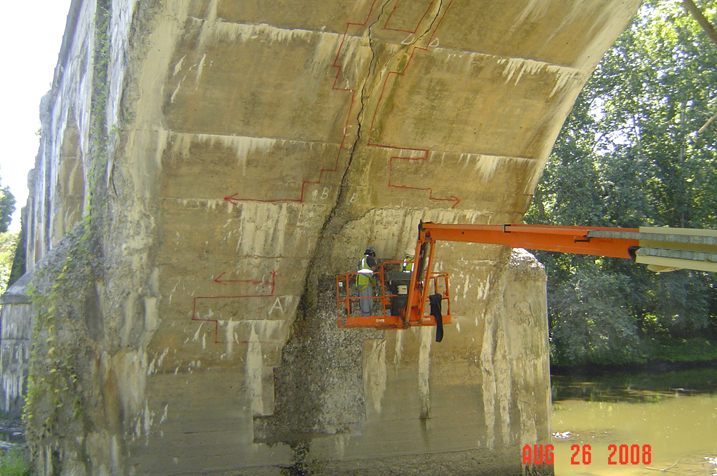

Preparation work under bridge to repair cracks and spalling areas.
|
|
|
|
|
Preparation work under bridge to repair cracks and spalling areas.
|
Preparation work under bridge to repair cracks and spalling areas.
|

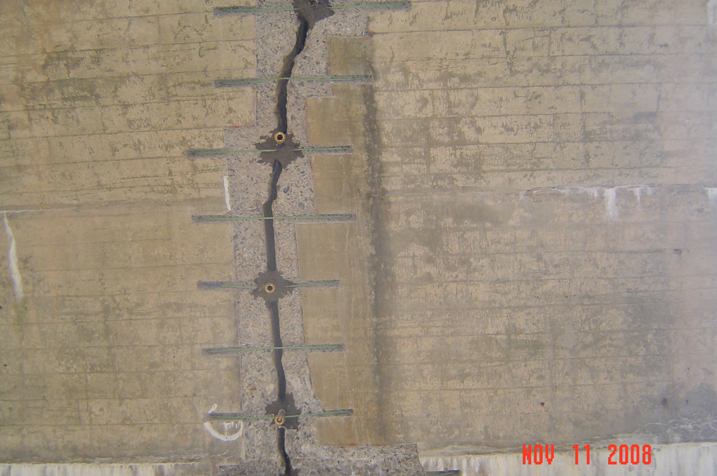

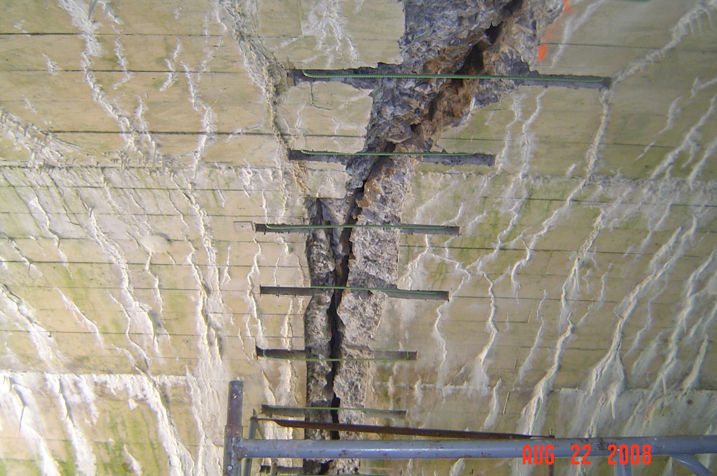

Spalling areas chipped out and rebar stitches installed around longitudinal cracks.
|
Grout ports installed in longitudinal cracks typical for the six spans.
|
|
|
|
|

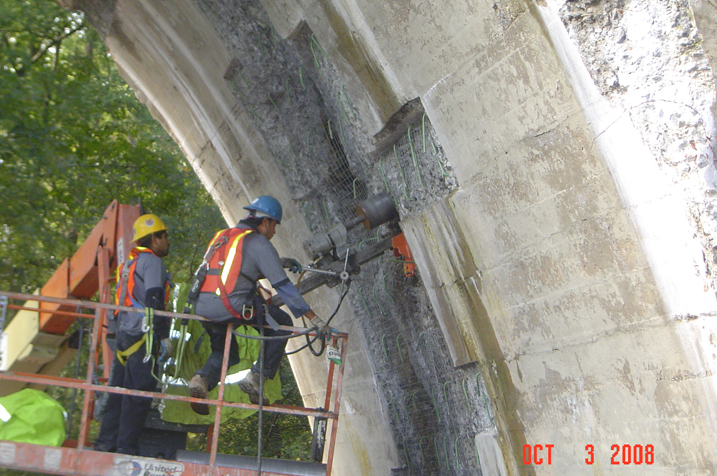

Core drilling new 6'' weep holes 8 feet deep in each of the 5 piers.
|
Pumping grout into ports to fill longitudinal cracks.
|
Pumping grout into ports to fill longitudinal cracks.
|

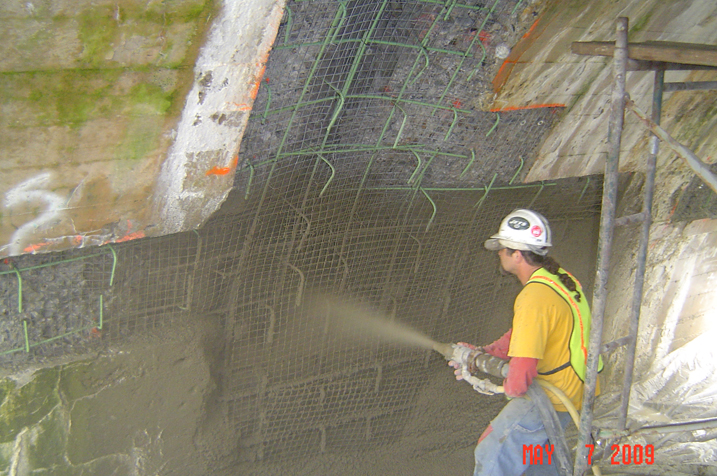

Shotcreting spalled areas.
|
|
|
|
|
Shotcreting spalled areas.
|

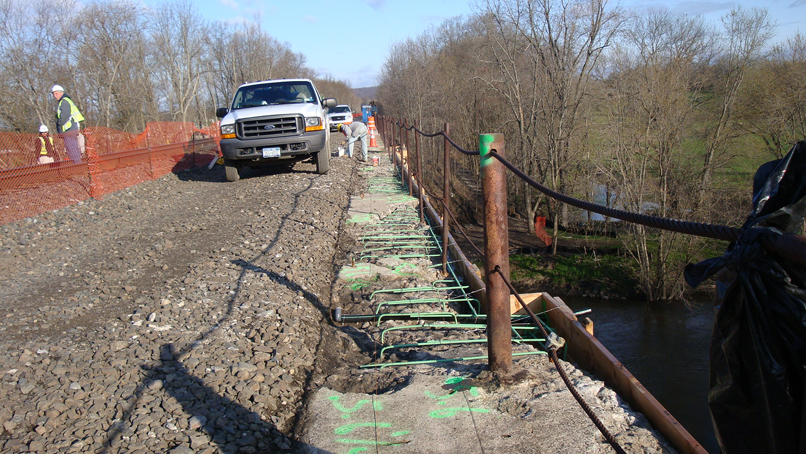

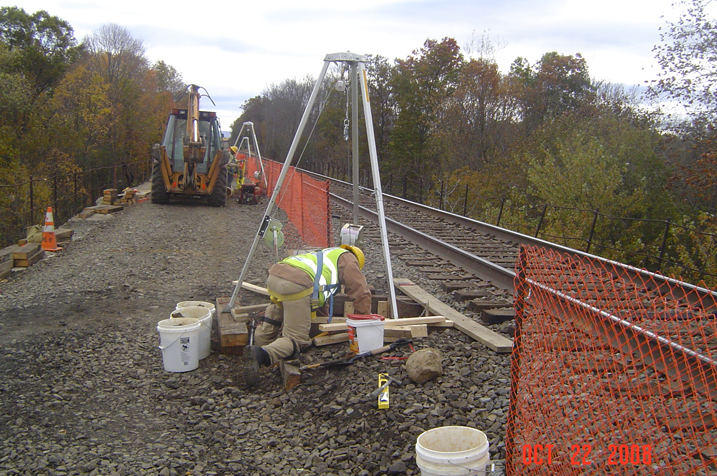

Beginning drainage pit excavation on top of bridge.
|
Beginning drainage pit excavation on top of bridge.
|

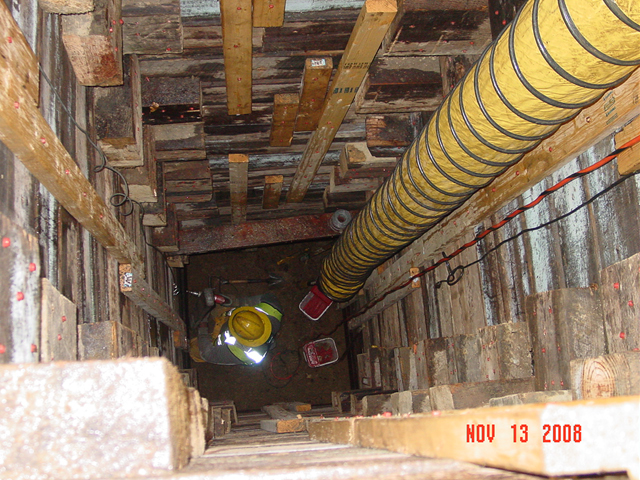

Typical drainage pit near completion. Five of these were installed at each pier
4' x 4' x 28' deep. Pits were hand dug and timbers were 4'' x 8''
|
|
|
|
|
Preparation work to repair top of spandrel walls on north and south sides of bridge.
|
Pouring new concrete on top of spandrel walls.
|

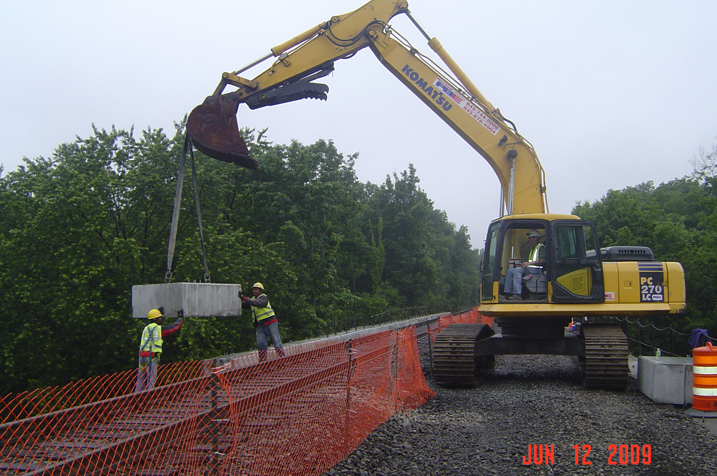

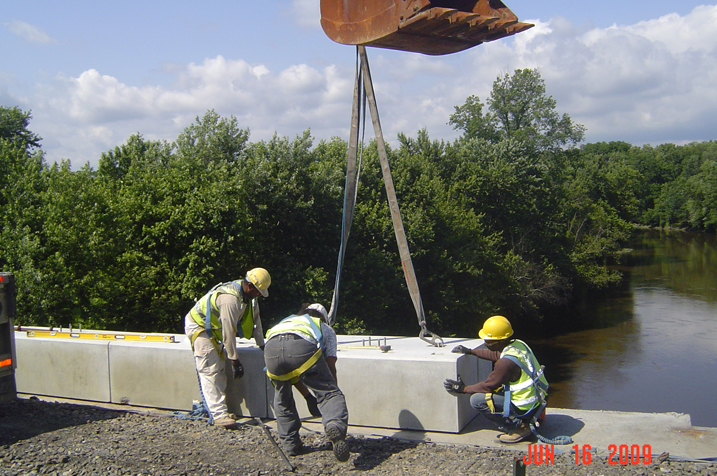

Placing new precast parapet walls on top of spandrel walls.
|
Placing new precast parapet walls on top of spandrel walls.
|
|
|
|

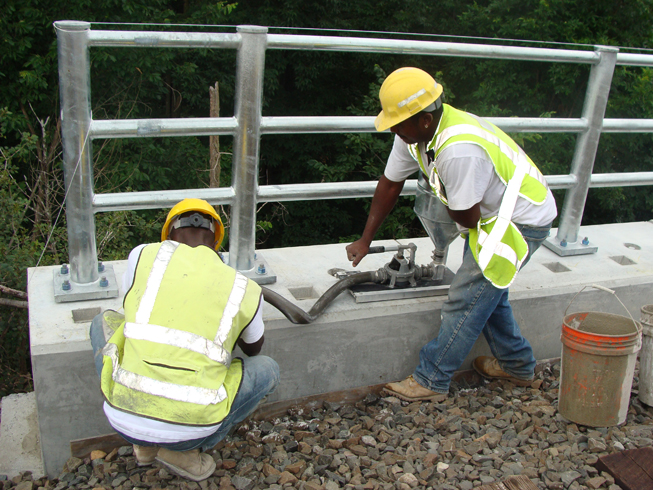

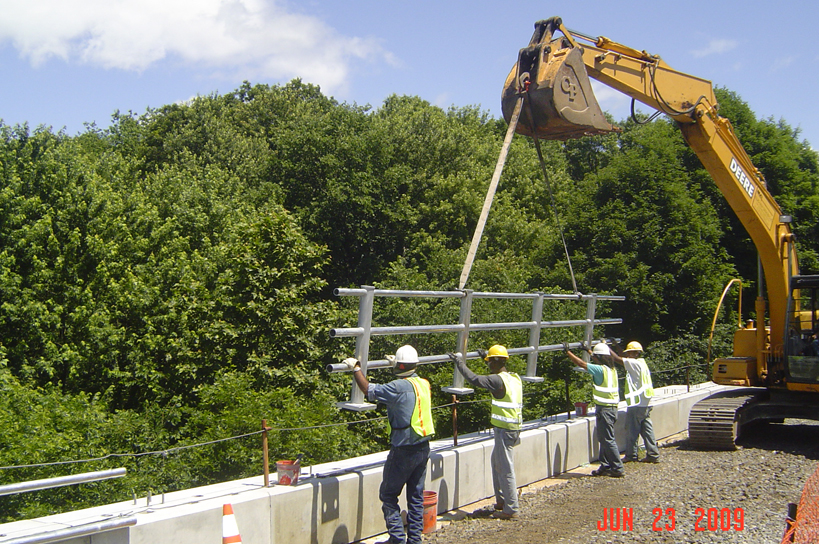

Installing new galvanized hand rails on top of precast parapets.
|
Pumping grout under new precast parapets to form bond and base on bridge.
|
Completed repairs to bridge with new parapets and railings.
|
